Getting Started¶
This is the zero-to-working-chart path. It takes about five minutes.
New to TaskNotes?
TaskNotes Gantt is a companion to TaskNotes, a
task-and-note plugin for Obsidian. TaskNotes is the system of record: it
owns what a task is, its scheduled / due dates, its blockedBy
dependencies, and its statuses — the Gantt just draws and edits them.
If those terms are new, skim the TaskNotes Core Concepts and Task Management pages first. You can still use the Gantt as a read-only timeline without TaskNotes — see Core Concepts → The two modes.
Requirements¶
- Obsidian 1.10.0+ (the Gantt is built on the official Bases API).
- The core Bases plugin enabled (Settings → Core plugins → Bases).
- TaskNotes — this plugin is built as a TaskNotes companion, so TaskNotes is strongly recommended: it's required for write-back, dependencies, colors, inline editing, and task menus. Without it you get only a read-only timeline (see the two modes).
1. Install the plugin¶
Until the plugin is in the community store, install it one of two ways.
- Install the BRAT plugin.
- In BRAT, Add a beta plugin and enter
renatomen/tasknotes-gantt. - Enable TaskNotes Gantt in Settings → Community plugins.
BRAT keeps you on the latest beta release automatically.
- Download
main.js,manifest.json, andstyles.cssfrom a release. - Put them in
<vault>/.obsidian/plugins/tasknotes-gantt/. - Enable TaskNotes Gantt in Settings → Community plugins.
Verifying the download (optional)
Release assets are built in GitHub Actions and carry a
build-provenance attestation.
You can verify a downloaded main.js was built from this repo's source:
2. Enable Bases¶
The Gantt is an Obsidian Bases view, so the core Bases plugin must be on: Settings → Core plugins → Bases.
3. Create a Base over your tasks¶
Create or open a Base whose query returns the notes you want on the timeline. With TaskNotes, that's typically your task notes. Without TaskNotes, it's any notes that have date properties.
4. Add a TaskNotes Gantt view¶
You can add the Gantt two ways — pick whichever fits how you work.
A · A standalone Base view. In the Base, add a new view and choose type TaskNotes Gantt. It fills its own tab — the natural home for a project's main timeline.
B · Embedded in a note. Drop a base code block into any markdown note and
give it an obsidianGantt view. The chart renders inline, right in the note:

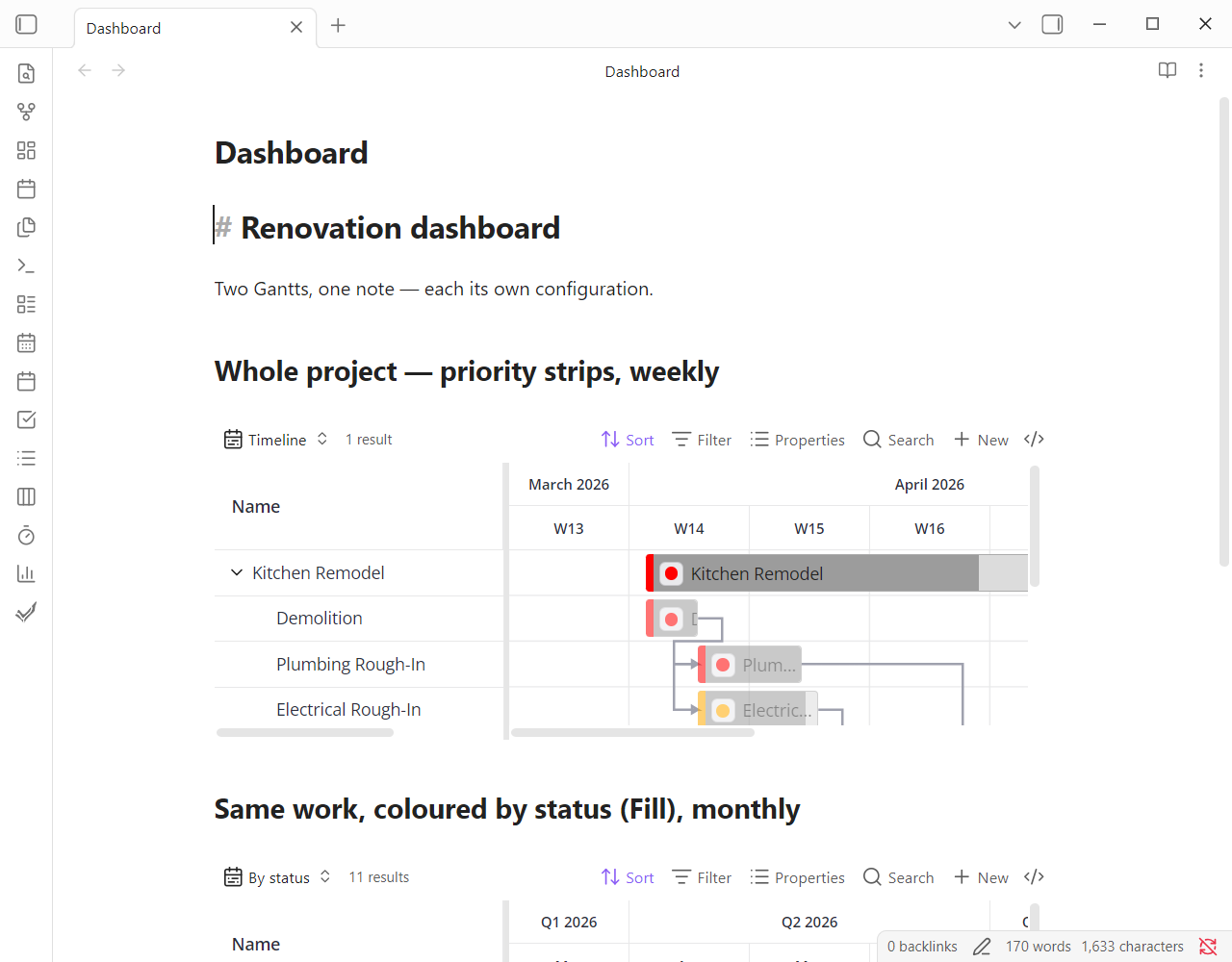

You can place several such blocks in one note, each with its own filter, scale, and colours — for example a weekly, priority-coloured view above a monthly, status-coloured view of the same project:
| Light | Dark |
|---|---|
![]() |
![]() |
Either way, an empty (or partially populated) chart appears — the next step maps your dates.
5. Map your date properties¶
Open the view options (the gear / view-settings menu) and confirm the field mappings under Fields:
- Start Date Property and End Date Property — with TaskNotes these
default to
scheduled/due. Without TaskNotes, point them at whatever date properties your notes use. - Parent Property (optional) — enables parent/child roll-up.
Every field mapping is documented in Settings → Fields.
6. You should now see a chart¶
Your notes render as bars along the timeline. From here:
- Companion mode: drag and resize bars, draw dependencies, edit cells inline, and right-click a bar for TaskNotes' own task menu.
- Standalone mode: you have a read-only timeline — pan, zoom, and read.
Add working time: a worked example¶
Once bars appear, you can tell the chart which days your team actually works. This walkthrough takes one team from no calendar to a chart that shows their working time. Each step links to the page that covers it in depth.
The situation. A small team works a four-day week, Monday to Thursday. Monday 6 April 2026 is Easter Monday, a public holiday. Alex, one of the team, is also on call on the second Saturday of every month, which in April is the 11th.
A calendar belongs to a task, not to a person: each task follows one calendar or calendar set through the view's Calendar Property. So the plan is three calendar notes and two sets:
| Note | Kind | Holds |
|---|---|---|
| Four-day week | calendar | Monday to Thursday |
| Alex on call | calendar | Monday to Thursday, plus the on-call Saturday |
| Public holidays | calendar | Easter Monday, and no working pattern |
| Team | calendar set | Four-day week and Public holidays |
| Alex | calendar set | Alex on call and Public holidays |
The team's tasks link to Team and Alex's on-call work links to Alex. The holiday is written once, in Public holidays, and both sets share it.
1. The team's working week¶
Run Create calendar from the command palette. The new note opens in the
calendar editor. Type Four-day week into
Name. The Working pattern starts at Monday to Friday; click Fri to
turn Friday off, then click Save. Written by hand, the result is:
2. The shared holiday list¶
Run Create calendar again and name this one Public holidays. Under
Non-working days, click + Add non-working day, pick 6 April 2026, name it
Easter Monday, and click Save.
This note must not keep the Monday-to-Friday pattern that Create calendar
writes. In a set, a day is off when any member has it off
(How the members combine),
so that pattern would turn Alex's on-call Saturday back into a day off. Run Open
calendar note as markdown and delete the pattern property, leaving:
If you open the note in the editor again, leave Working pattern alone: using its controls writes a pattern back (The working pattern builder).
3. Alex's week, with the on-call Saturday¶
Run Create calendar a third time, name it Alex on call, click Fri off
as in step 1, and save.
The on-call Saturday has to live in this calendar. Putting it in a set would not help: as step 2 showed, a task that links to a set gets every member's days off, so a set can take working days away but never add one. Extra working days go in an availability block. The editor does not edit blocks yet, so run Open calendar note as markdown and add one to the frontmatter. A block is a nested list, which is easiest to type in Source mode:
tngantt: calendar
pattern: "FREQ=WEEKLY;BYDAY=MO,TU,WE,TH"
non_working: []
availability:
- pattern: "FREQ=MONTHLY;BYDAY=2SA"
hours:
- "09:00-13:00"
BYDAY=2SA is the second Saturday of each month. A block has no anchor date, so
its rule has to pick its days by itself, as this one does. A rule that counts from
a start date, one with INTERVAL above 1, COUNT or UNTIL, adds no working
days in a block, so "every other Saturday" cannot be written as one. The chart works in whole days,
so the Saturday counts as a full working day whatever its hours
(Days, not hours).
4. The two sets¶
Run Create calendar set and name it Team. Under Member calendars, click
+ Add member twice, enter [[Four-day week]] and [[Public holidays]], and
save. Then create a second set, Alex, with [[Alex on call]] and
[[Public holidays]]. See Calendar sets.
5. Link the tasks, and set the Calendar Property¶
Give each team task the property calendar: "[[Team]]", and Alex's on-call task
calendar: "[[Alex]]". The example has three tasks, each with a start date and an
estimate in minutes (1,440 to a day) but no due date:
| Task | scheduled |
timeEstimate |
calendar |
|---|---|---|---|
| Plan the sprint | 2026-04-02 | 4320 (three days) | "[[Team]]" |
| Write the release notes | 2026-04-09 | 2880 (two days) | "[[Team]]" |
| Upgrade the database | 2026-04-09 | 2880 (two days) | "[[Alex]]" |
Then open the Gantt view's settings and, in the Fields group, set
Start Date Property to scheduled,
Time Estimate Property to
timeEstimate and Calendar Property
to calendar, the property names in the table. Calendar Property starts blank,
and while it is blank no task follows a calendar.
6. Count working days¶
In the Timeline group of the same menu, set Estimate meaning to Working days (skip non-working) and Non-working-day rendering to Split segments. What each one does is on Calendars and working time.
7. Check the selection¶
Run Select calendars… to see which calendars the chart shades. Until you change anything there, the chart shades the calendars your tasks link to (Choosing which calendars shade), so here the three calendars and both sets are already ticked. Default calendar is ticked too while Highlight weekends is on, as it is by default and as it was for the chart below. Nothing needs changing for this example. How ticking and unticking a set or its members works is under Select calendars….
Reading the chart¶
| Light | Dark |
|---|---|
![]() |
![]() |
- Fridays and weekends are shaded.
- Two days are striped instead. Stripes mark a conflict: the calendars on show disagree about the day. Public holidays has Monday 6 April off, while both working weeks would work it. Alex on call works Saturday 11 April, while Four-day week does not. The banner counts conflict days over every date the chart shades, not just the days on screen, which is why it says 6 here (The calendar-status banner).
- Plan the sprint starts on Thursday 2 April with an estimate of three days. It works that Thursday, skips Friday, the weekend and Easter Monday, which are drawn faint, and ends on Wednesday 8 April.
- Write the release notes and Upgrade the database both start on Thursday 9 April with an estimate of two days. The team's task skips Friday to Sunday and ends on Monday 13 April. Alex's task skips only Friday, works the on-call Saturday, and ends there.
- Each bar's right edge is torn because none of these tasks has a due date: the plugin worked each end out from the estimate.
To see every cue on the chart explained, click the Legend button in the chart's top-right corner. See The legend.
